Monday, December 20, 2010

WEEK 22 - 12/12/10 - 12/18/10

The weather has been extra cold this last week and has really slowed down progress. We hope to see better weather next week and are doing all we can to push through with what work can be done in these conditions. HVAC duct work, electrical rough-in, and fire suppression piping have been able to continue but with some delay.

Weather Conditions 7-Day Weather Forecast

Thursday, December 2, 2010

WEEK 19 - 21 - 11/21/10 - 12/11/10

Project is progressing well. Framing and roofing are complete. The plumbing rough is complete and the HVAC and electrical are more than half way done. Steel door frames are being installed. Drywall has begun, starting with the mezzanine areas. The exterior is well underway on receiving a Tyvek wrap. Storefront entryways are complete and brick masonry has just begun. All concrete curb has been poured, and we will start asphalt paving just prior to turnover. We are scheduled to start drywall in the classrooms next week.

Curbing
Brick Installation

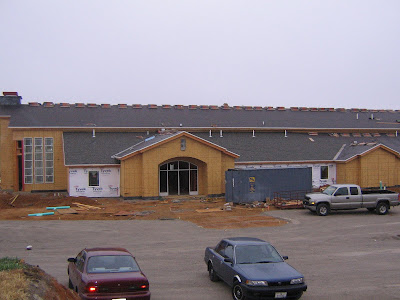

Framing


Storefront Entry
Plumbing
Electrical
Steel Door Frames
Drywall

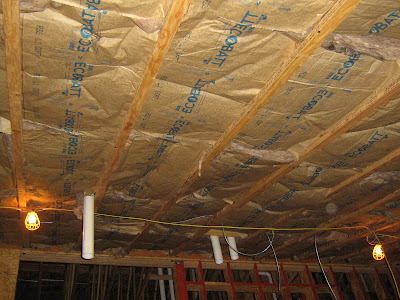

HVAC and Fire Suppression Lines


Site

7-Day Weather Forecast

Tuesday, November 16, 2010

WEEK 16 - 18 - 10/31/10 - 11/20/10

The project is progressing well. We will finish the roofing today. We have started mechanical, electrical, plumbing, and fire sprinkler rough inside the building. The rock base for the paving has been installed. Some of the storefront windows and doors have been installed. The drywall for the mezzanine is scheduled for 11/22 and masonry will start the week of 11/29.




7-Day Weather Forecast

Sunday, October 31, 2010

WEEK 14 & 15 - 10/17/10 - 10/30/10

The past couple weeks we have: continued framing, installed gravel base in parking area, poured portions of the curb&gutter and started mechanical and electrical roughs. The framing has been slowed by recent heavy rains. Our schedule for the next few weeks include: start roofing 11/2, start fire sprinkler, continue with MEP roughs, pour more site concrete, and begin insulation.
Lots of Rain


Parking Gravel Base and Gurb & Gutter


Storage Building Foundation
Grease Trap
Mechanical and Electrical Roughs


7-Day Weather Forecast

Sunday, October 17, 2010

WEEK 12 & 13 - 10/3/10 - 10/16/10

The past few weeks has been more framing. All the site utilities are complete. We will pour the pavilion and storage building foundations next week. The MEP subcontractors will begin 'rough-in'(i.e. install boxes, conduits, pipes, duct, etc. inside the walls) the last week of October. Roofing is scheduled to start the week of 11/1. The framing will finish the first week of November.



Storage Building Foundation
Pavilion Foundation
Storm Sewer Inlet
Project Materials
Brick Mock-up
